Last updated: April 18, 2026
Flow-based scheduling is a production management approach that prioritizes moving work through the shop as quickly as possible by reducing queues and work-in-process (WIP), rather than maximizing machine utilization. In job shops, this produces shorter lead times, more predictable delivery, and higher throughput – without adding capacity.
TL;DR: Flow-based scheduling focuses on moving work through your shop faster by reducing queues and work in process (WIP), not by maximizing machine utilization. The counterintuitive result: shorter lead times, more predictable delivery, and higher throughput. In complex job shops where the constraint moves, it is the only approach that works consistently.
Key Takeaways:
- Flow-based scheduling reduces WIP to shrink queue time and lead time across the whole shop
- High-utilization rules are mathematically guaranteed to increase queue time (Kingman equation)
- The secret to on-time delivery is to STOP focusing on efficiency
- In complex job shops where the constraint moves week to week, flow scheduling outperforms traditional constraint-based methods
- Shops running VSS, a flow-based scheduling system, see an average 87% WIP reduction and 82% lead-time reduction
In Velocity Scheduling System, we focus on flow-based scheduling and flow manufacturing, specifically the physical flow in manufacturing. In Velocity Pricing System, we focus on the flow of money and information. For this article, we are referring to physical flow.
Physical flow is the rate of movement or elapsed time from start to completion of the manufacturing process.
Flow, or Velocity as we call it in VSS, is the time it takes from when we start a job until we complete it. This is also commonly called lead-time. The fewer the disruptions to flow, the faster work moves through the shop, the shorter the lead-time, and the faster the velocity.
We also look at the rate of flow by taking into account job size. Smaller jobs should flow faster than larger jobs.
In Theory of Constraints, you will hear “Balance flow, not capacity.” This is an extremely important, often overlooked aspect of improving operations. Flow was one of the main concepts in The Goal by Eliyahu Goldratt. Most people read The Goal and focused on finding and eliminating the constraint. But for complex job shops where the constraint can move week to week or even day to day, the flow concept is much more powerful.
What Is Flow-Based Scheduling?
Flow-based scheduling focuses on the movement of WORK through your shop, not on keeping every machine or person busy.
It is simple. Improvement in physical flow occurs when queues are reduced. And to reduce queues, you must reduce work in process (WIP). We have previously discussed Little’s Law, how and why WIP reduction is so important, in these articles:
- Job Shop Scheduling: The Secret to Getting On Time and Reducing Lead Times
- Scheduling Job Shops: Flow is KEY!
As discussed there, reducing WIP produces a cascade of benefits:
- Queue time reduces
- Lead-time reduces
- Lead-time predictability increases
- On-time delivery increases
- Quality increases
- Cash flow increases
Plossl’s Law: All benefits will be directly related to the speed of flow of materials and information.
Why High Utilization Rules Hurt Your Shop
Here is where most scheduling approaches go wrong.
The instinct to keep every machine running as much as possible is natural. Idle equipment feels like waste. Your ERP likely reports utilization and efficiency metrics as key performance indicators. Everything in your training points the same direction: keep the machines busy.
But there is a mathematical problem with that instinct.

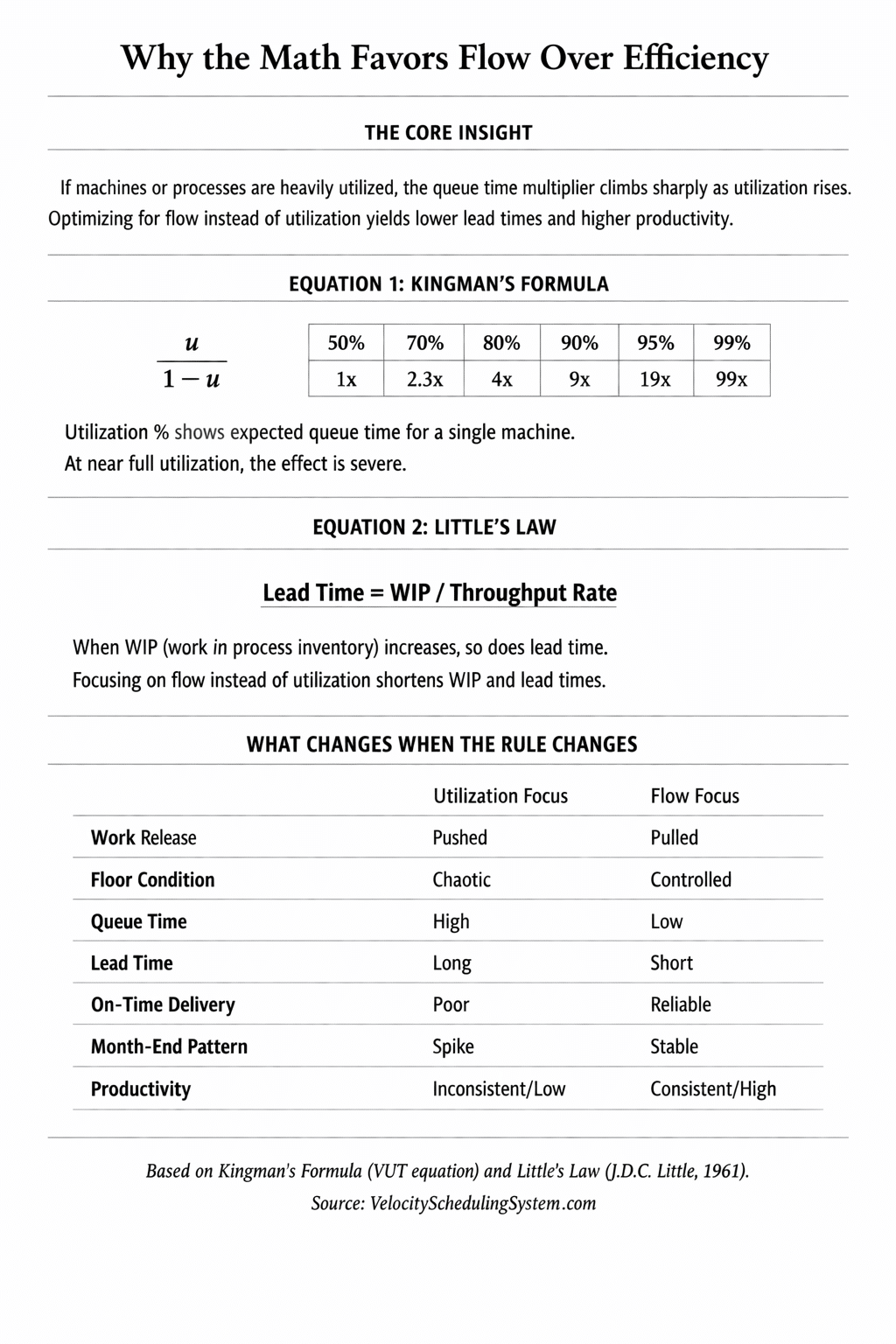

The Kingman equation describes the relationship between utilization and queue time in manufacturing systems. The formula shows that as machine utilization approaches 100%, queue time does not increase linearly. It explodes exponentially.
At moderate utilization, queue times stay manageable. Push utilization toward 95% or 100%, and queue times become enormous. The machine is busy. The job is still late. And both of those things are happening at the same time, because of each other.
The SECRET to getting on time and reducing lead times is to STOP focusing on efficiency. It sounds like heresy, I know – but that is the secret.
When you shift your focus to flow, you accept some machine idle time in exchange for dramatically shorter queue times across the whole shop. The trade: machines work less, jobs move faster, customers get deliveries on time.
Your competitors are focused on utilization right now. While they push equipment to 95% and wonder why lead times keep growing, you can operate at a lower utilization rate and ship on time. That is a competitive advantage most shops never discover because the math contradicts the instinct.
Obstacles to Flow
Identifying what slows work through your shop is the starting point for every improvement. Rami Goldratt’s “Obstacles to Flow” framework formalizes this as a systematic search: before you can improve flow, you have to name what is blocking it.
Most shops have the same obstacles. Batch processing that releases too much work at once. Efficiency-based priorities that route jobs to keep machines busy rather than to move the highest-priority work forward. Local optimization decisions made at each workstation without visibility to the system impact.
The Five Focusing Steps from Theory of Constraints give you a structure to address obstacles one at a time: identify the constraint, exploit it, subordinate everything else to it, elevate it, and then repeat. In complex job shops, the twist is that the constraint moves. Identifying it once and building a fixed policy around it is not enough.
Flow-based scheduling embeds the subordination principle into daily operations. Every scheduling decision is subordinated to keeping the highest-priority work moving, regardless of where the constraint sits on any given day. The result is a shop that responds to the real bottleneck rather than the assumed one, and that is what produces consistent on-time delivery when product mix and routings shift week to week.
WIP Reduction and the Math Behind Flow
Little’s Law, formalized by MIT professor John Little in 1961, states:
Lead Time = WIP / Throughput Rate
Lead time is directly proportional to the amount of WIP in your shop. Cut WIP in half, lead time cuts in half, assuming throughput rate stays constant.
What happens in most shops is the opposite. WIP keeps growing as jobs pile up waiting for resources, and lead times grow with it. More jobs on the floor create more scheduling complexity, more expediting, more disruption to planned sequences, and even longer delays. It is a self-reinforcing cycle.
The flow-based scheduling approach breaks this cycle by controlling how much WIP enters the shop at any given time. Jobs wait in a controlled staging area until there is room for them in production. This seems counterintuitive – should not we start jobs as soon as possible? – but the data says otherwise.
In a job shop with too much WIP, every job is late. In a job shop with controlled WIP, most jobs are on time. The difference is not capacity. It is flow.
Here is something to check this week: Pull a list of jobs shipped in the last six months. Calculate how many days early and how many days late each job shipped. If you have jobs shipping both early and late by significant margins, you have a WIP problem. You are consuming capacity on jobs not yet due while higher-priority jobs wait.
That data is already in your ERP. Most owners have never looked at it this way.
Flow-Based Scheduling in Complex Job Shops
In complex job shops, where jobs have variable routings and the constraint shifts from day to day, traditional scheduling approaches break down quickly.
Standard drum buffer rope scheduling assumes a fixed constraint. It protects that constraint and subordinates everything else to it. In a flow shop or a simple manufacturing environment with stable routings, that works well. But in a complex job shop where every job takes a different path, the constraint can be a different machine on different days.
If you schedule around a constraint that keeps moving, your schedule is obsolete before you can act on it.
Flow-based scheduling sidesteps this problem entirely. Rather than trying to schedule every job on every machine, it focuses on controlling WIP and releasing work in a sequence that keeps the highest-priority jobs moving. The Velocity Board makes priorities visible to everyone on the floor without requiring a complex schedule that is constantly going stale.
This is why drum buffer rope works in environments with stable constraints, but flow-based scheduling is the better fit for complex job shops. It is not one or the other across all environments. It is the right tool matched to the right environment.
Flow-Based Scheduling Results
Troy Parker, Sr. Director of Operations at a California manufacturer, put it simply: “Our shop improved our lead-time to our customers by more than 75%. We went from 18 days to less than 5 days on average.”
That is not unusual. Rick Lightcap, a custom heat exchanger and tank manufacturer, went from shipping 1 job every two weeks to 5 jobs per week – that is 10X more work completed – with 100% on-time delivery on all new jobs since starting VSS.
The results show up in the team too. Daniel Heerding, three months into the program, reported: “Our job shop is calm and ordered with almost no visible work in process. Our due date performance is currently tracking at 100%.” His scheduler
